Smooth Streets Program

Active Construction Segments:

Project Update: Phase 5 (As of October 1, 2026)

Phase 5 of the Smooth Streets Program is actively moving forward.

Our contractor, Teichert Construction, is currently performing Full Depth Reclamation and Paving on various street segments. See below for schedule.

Project Timeline

  • Estimated Schedule for FDR/Mill and Overlay:

Tentative Paving Schedule - Subject to Change

Street Name

Pavement Treatment

Estimated Start

Estimated Completion

Echo Ave

Full Depth Reclamation

9/14/2026

9/22/2026

Noe Ave

Full Depth Reclamation

9/14/2026

9/22/2026

Iowa Dr

Full Depth Reclamation

9/16/2026

9/24/2026

Oregon Ave

Full Depth Reclamation

9/16/2026

9/24/2026

Tilia St

Full Depth Reclamation

9/18/2026

9/29/2026

Pierce St

Full Depth Reclamation

9/22/2026

9/30/2026

Oxford Ave

Full Depth Reclamation

9/22/2026

9/30/2026

Juniper St

Full Depth Reclamation

9/24/2026

10/6/2026

29th Ave

Full Depth Reclamation

9/24/2026

10/6/2026

Terrace Way

Full Depth Reclamation

9/24/2026

10/6/2026

San Benito St

Full Depth Reclamation

9/28/2026

10/7/2026

Rolling Hills Ave

Full Depth Reclamation

9/28/2026

10/7/2026

Idaho St

Grind and Pave

9/24/2026

9/24/2026

Tulane Ct

Grind and Pave

9/24/2026

9/24/2026

Lula Belle Lane

Grind and Pave

10/2/2026

10/2/2026

Bettina Ave

Grind and Pave

10/7/2026

10/8/2026

Highview Dr

Grind and Pave

10/7/2026

10/8/2026

Overland Dr

Grind and Pave

10/2/2026

10/2/2026


  • Weather Impact: This work requires ideal conditions and is highly weather-dependent. Schedules may shift accordingly.

The street segments in (Phase 5) are shown below:

Street Name

From

To

Treatment

29th Ave

Alameda De Las Pulgas

Juniper St

Full Depth Reclamation

Bettina Ave

City Limit

42nd Ave

Mill and Overlay

Echo Ave

S Norfolk St

Lodi Ave

Full Depth Reclamation

Highview Dr

City Limit

Newlands Ave

Mill and Overlay

South Idaho St

Sunnybrae Blvd

10th Ave

Mill and Overlay

Iowa Dr

Parrott Dr

Nevada Ave

Full Depth Reclamation

Juniper St

30th Ave

28th Ave

Full Depth Reclamation

Lula Belle Ln

Hacienda St

Flores St

Mill and Overlay

Noe Ave

S Norfolk St

Echo Ave

Full Depth Reclamation

Oregon Ave

St. John's Cemetery

Bucknell Dr

Full Depth Reclamation

Overland Dr

Woodberry Ave

Palos Verdes Dr

Mill and Overlay

Oxford Ave

Hamlet Ave

South Norfolk St

Full Depth Reclamation

Pierce St

Speers Ave

Queens Ave

Full Depth Reclamation

Rolling Hills Ave

Alameda De Las Pulgas

Hacienda St

Full Depth Reclamation

Rolling Hills Ave

Hacienda St

Cul-De-Sac

Mill and Overlay

San Benito St

San Miguel Wy

Antioch Dr

Full Depth Reclamation

Terrace Wy

Alameda De Las Pulgas

Isabelle Ave

Full Depth Reclamation

Tilia St

Hobart Ave

Borel Ave

Full Depth Reclamation

Tulane Ct

Cul-De-Sac

Tulane Rd

Mill and Overlay


FAQs for Phase 5 of Smooth Streets Program (English)
FAQs for Phase 5 of Smooth Streets Program (Spanish)

FAQs for Phase 5 of Smooth Streets Program (Chinese)

We appreciate your cooperation and patience as we work to improve our city streets.

Residents are advised to monitor for additional notices and temporary “No Parking” signage on affected streets as the start approaches and move cars as needed to prevent any delays to work.

Program Description

The Smooth Streets Program reconstructs roads that have reached the end smoothstreetsof their service life.

This is a special program that addresses streets which can no longer be preserved as part of our regular road maintenance. Approximately 22 miles of streets have been identified for reconstruction based on visual inspection and their Pavement Condition Index.

Since its inception in 2013, the program has restored 15 miles of our City streets. In 2015, local voters approved Measure S, a quarter-cent sales tax extension that supports community-identified priorities like the Smooth Streets Program.

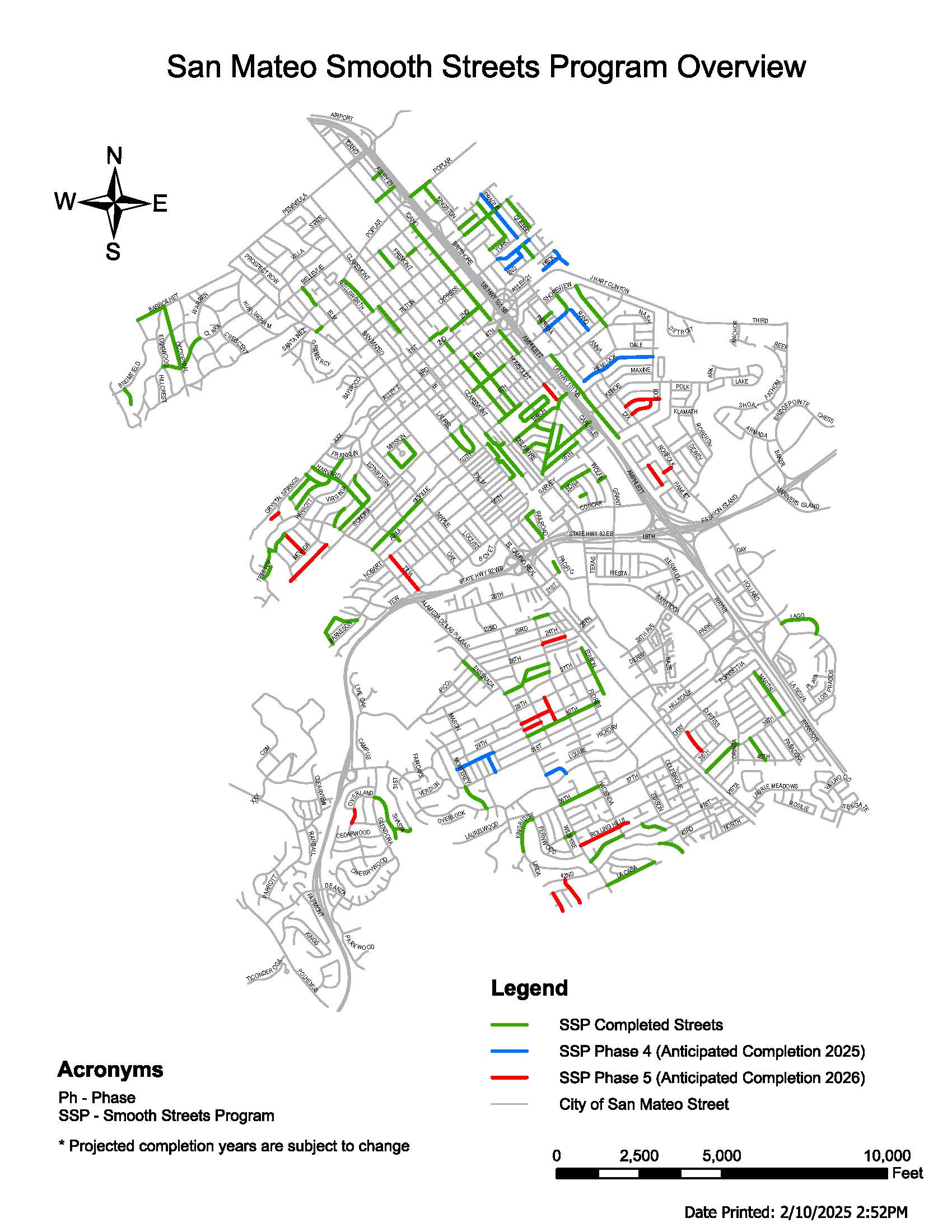

Program Map
