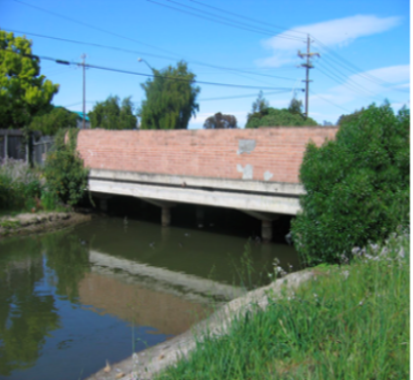

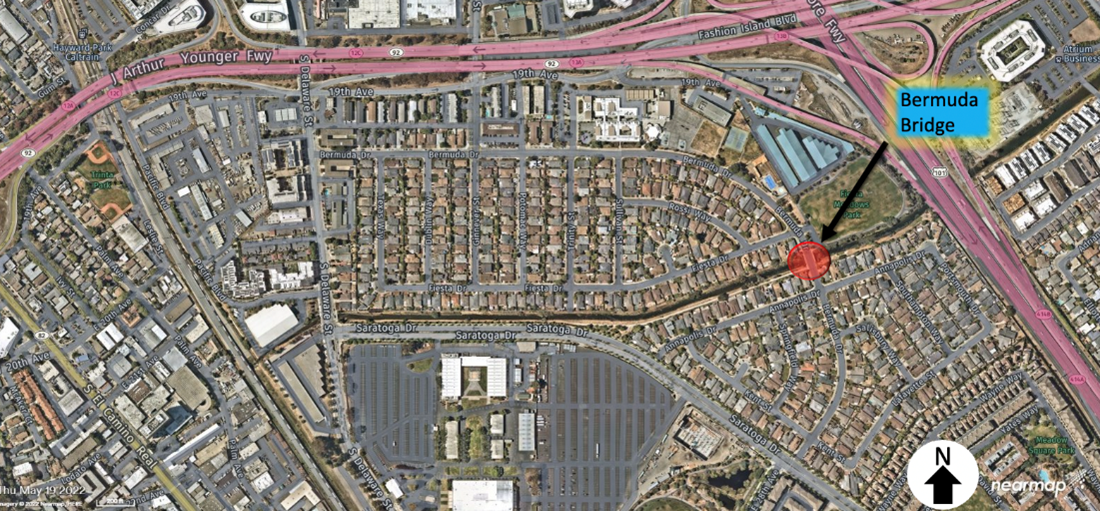

Bermuda Drive Bridge Replacement Project
Stay up-to-date on the latest developments and progress of the Bermuda Drive Bridge Replacement Project!
Project Details
The Bermuda Drive Bridge Replacement Project is a vital public infrastructure improvement undertaken to address structural deficiencies and seismic risks associated with the existing 1954 structure. This project will enhance the long-term safety, durability, and performance of the bridge while also improving aesthetics for vehicular and pedestrian users, as well as the broader public community.
Construction Timeline
January 2026 (Phase 1): Construction mobilization
February 2026: Pile milling and Fiesta Meadows Park southwest parking lot closure
April 2026: Trail closure and dewatering activities
April 2026 - October 2026: Pile drilling and west side roadway bridge construction
November 2026 - March 2027: Winter construction shutdown
April 2027 (Phase 2): Remobilization & trail closure
April 2027 - July 2028: Dewatering activities; East side roadway bridge construction; Sidewalk construction; Fiesta Meadows Park parking lot grinding and overlay
July 2028: Construction is complete. Normal vehicular and pedestrian access resumes
Phasing
Phase 1 (January 2026 - October 2026): East side of the bridge will remain open.
Phase 2 (April 2027 - July 2028): West side of the bridge will remain open.
Disclaimer: All dates are tentative and subject to change due to weather, permitting, or unforeseen conditions.
Traffic Impacts
Traffic over the bridge will be reduced to one-way operation, with stop signs placed to ensure adequate sight distance for approaching vehicles.
Project Benefits
- Improved Safety: Enhanced seismic resilience and reduced risk of failure.
- Enhanced Infrastructure: Modernized design and compliance with current standards.
- Increased Durability: Long-lasting materials for extended service life.
- Reduced Maintenance Costs: Modernized design lowers future maintenance expenses.
